Managing inventory in project-driven industries demands a fundamentally different approach than continuous manufacturing or retail operations. Each project carries unique specifications, timelines, and material requirements making standardized inventory practices ineffective and costly. This guide reveals enterprise-grade inventory management techniques specifically designed for project industries, enabling planners to reduce waste, optimize cash flow, and deliver projects on schedule and within budget.
Understanding Inventory Challenges in Project Industries
Project-based industries including construction, engineering, oil & gas, infrastructure, and large-scale manufacturing face inventory challenges that differ fundamentally from repetitive production environments.
Key Characteristics of Project Inventory:
- Non-repetitive demand patterns: Each project has distinct material specifications and quantities
- Concentrated time horizons: Materials must arrive precisely when needed, not before or after
- Site-specific constraints: Storage, handling, and security requirements vary by location
- Regulatory and compliance complexity: Different jurisdictions impose unique material standards
- High carrying costs: On-site inventory ties up capital and increases storage expenses
- Long procurement lead times: Critical materials often require 6-12 week lead times
- Obsolescence risk: Project-specific materials become stranded assets if scope changes
Without specialized inventory techniques, project planners typically over-purchase (fearing shortages), leading to excess stock, higher carrying costs, and project cost overruns.

Top 7 Best Techniques to Manage Inventory in Project Industries
Schematic: Strategic Inventory Management for Project-Based Operations
1. Implement Rolling Wave Planning with Inventory Staging
Rolling wave planning is a hierarchical scheduling approach that synchronizes inventory procurement with project execution phases.
How It Works:
- Near-term (0-8 weeks): Detailed material requirements and procurement orders
- Mid-term (8-16 weeks): Aggregate forecasting based on design phase completion
- Long-term (16+ weeks): Strategic sourcing and lead-time management
Application in Project Industries:
For a commercial construction project, you plan foundation materials (concrete, rebar, formwork) with week-level precision. Structural steel procurement runs on a 12-week rolling forecast, updated bi-weekly as design details finalize. Interior finishes are forecast monthly, allowing flexibility as owner preferences evolve.
Benefits:
- Reduces over-purchasing by 20-35%
- Minimizes storage space and carrying costs
- Enables rapid scope change accommodation
- Improves cash flow by aligning purchases with spend schedules
Project-specific MRP differs from manufacturing MRP in one critical way: demand is driven by the project schedule and work breakdown structure (WBS), not forecasted sales.
Best Practice Implementation:
Key Steps:
- Decompose the project schedule into discrete work packages and milestones
- Create phase-specific bills of materials (BOMs) instead of single project BOM
- Identify critical long-lead items (items with 8+ week procurement times)
- Reverse-schedule from need dates to purchase order dates, accounting for:
- Supplier lead times
- Transportation and customs clearance
- On-site receiving and inspection
- Storage and staging time
5 Establish procurement windows to trigger orders at optimal times
Real-World Example:
An offshore oil & gas platform project requires 450 tons of specialized subsea piping. Instead of ordering the entire volume upfront (tying up $2.8M for 18 months), the MRP-based approach:
- Orders 40% at month 3 (fabrication lead time: 16 weeks, needed at month 7)
- Orders 35% at month 5 (needed at month 10)
- Orders 25% at month 7 (final commissioning phase)
Result: Capital tied up is reduced by 60%, and flexibility to incorporate design changes improves by 40%.
3. Implement Vendor-Managed Inventory (VMI) and Consignment Agreements
For high-value, long-lead items, shifting inventory ownership to suppliers reduces project carrying costs and improves cash flow.
Types of Vendor Management Arrangements:
A Consignment Stock:
- Supplier maintains ownership until material is used on-site
- Project pays only when consumption occurs
- Ideal for: mechanical equipment, specialized hardware, safety components
B Vendor-Managed Inventory (VMI):
- Supplier monitors on-site stock levels and replenishes automatically
- Project provides visibility into schedule and consumption forecasts
- Ideal for: consumables, fasteners, small tools, PPE
C Just-In-Time (JIT) Delivery:
- Materials arrive in precise quantities on scheduled need dates
- Requires reliable supplier performance and supply chain visibility
- Ideal for: finishes, fixtures, final assembly components
Negotiation Framework:
When structuring VMI agreements:
- Provide 12-16 week rolling forecasts to suppliers
- Guarantee minimum purchase volumes to secure better pricing
- Establish performance metrics: on-time delivery >98%, quality defects <0.5%
- Include penalty and incentive clauses tied to delivery performance
Benefits:
- Reduces on-site inventory by 40-60%
- Improves cash flow: pay-on-use vs. pay-upfront
- Reduces warehouse space requirements and associated costs
- Supplier bears obsolescence risk if scope changes
4. Adopt Integrated Inventory Tracking with Real-Time Visibility
Modern project inventory management requires end-to-end visibility: from supplier warehouse through transportation to on-site storage to final installation.
Technology Stack for Project Inventory:
Function | Technology/Tool | Purpose |
Demand Planning | ERP + Project Management Integration | Synchronize schedule changes with material needs |
Procurement Tracking | Supplier Portal / EDI | Real-time purchase order status |
In-Transit Visibility | GPS / Telematics | Location and ETA of shipments |
On-Site Tracking | RFID / Barcode Scanning | Stock level accuracy and location |
Consumption Tracking | Mobile Apps / Timesheets | Actual material usage vs. forecast |
Reporting Dashboard | Business Intelligence Tools | KPIs: variance, aging, carrying costs |
Implementation Approach:
- Baseline current state: Document existing inventory processes, data silos, and visibility gaps
- Select integrated platform: Choose ERP/project management system with native MRP and inventory modules
- Establish master data: Create standardized item master, BOMs, and locations across all projects
- Deploy in phases: Start with pilot project; expand to enterprise portfolio
- Train teams: Supply planners, site managers, and procurement teams need hands-on training
Key Metrics to Monitor:
- Inventory Turnover Rate: Number of times inventory is consumed and replenished (target: 4-8x annually for projects)
- Stockout Rate: Percentage of demand met from existing inventory (target: >95%)
- Carrying Cost as % of Project Value: (Average inventory value × carrying cost rate) / project budget (target: <2%)
- On-Time Delivery Rate: % of materials arriving on the scheduled need date (target: >98%)

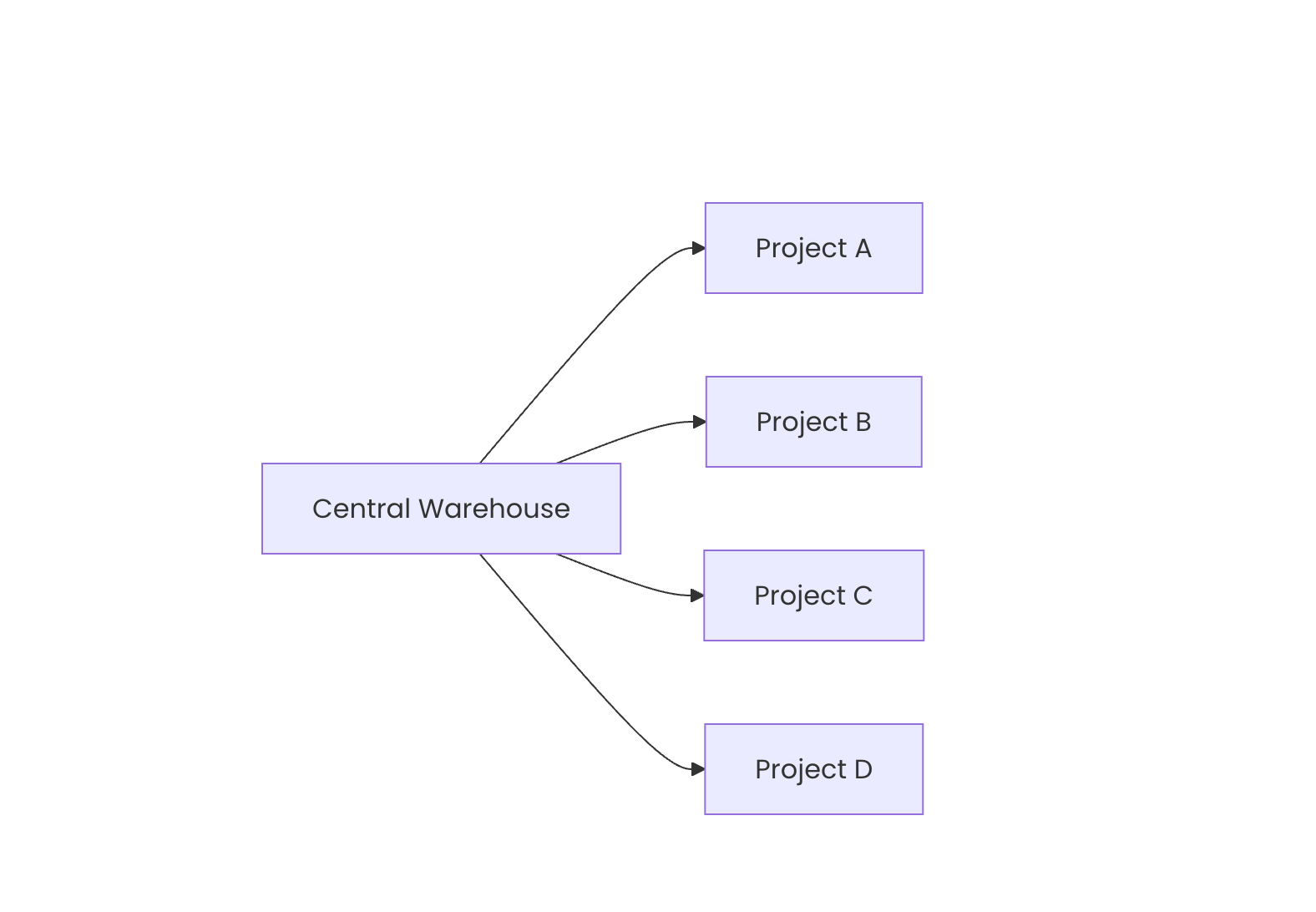

5. Establish Centralized vs. Distributed Inventory Strategy
Large, multi-project programs must decide whether to maintain centralized inventory hubs or distribute stock to individual project sites.
Centralized Inventory (Hub Model):
Best for: Programs with 5+ concurrent projects, reusable materials (formwork, equipment, tools)
Advantages:
- Lower total inventory levels (shared buffer stock)
- Better utilization of reusable equipment
- Easier inventory control and auditing
- Economies of scale in procurement
Disadvantages:
- Higher logistics costs (inter-site transfers)
- Potential delays if stock allocation is mismanaged
- Requires sophisticated scheduling and visibility
Distributed Inventory (Site-Based Model):
Best for: Geographically dispersed projects, specialized/site-specific materials
Advantages:
- Faster material availability on-site
- Reduces inter-site logistics costs
- Project managers have autonomy
Disadvantages:
- Higher total inventory (duplication across sites)
- Difficulty managing common items across projects
- Harder to identify and reallocate excess stock
Hybrid Approach (Recommended):
Maintain centralized hub for:
- Long-lead, high-value items (subsea equipment, large machinery)
- Common, reusable tools and formwork
- Emergency/contingency stock
Maintain site-based inventory for:
- Consumables with short shelf life
- Site-specific materials
- Small, low-cost items
6. Deploy Demand Forecasting with Scenario Planning
Project scope changes are inevitable. Inventory strategies must be flexible enough to accommodate design modifications, scope additions, and schedule delays without excess waste.
Forecasting Approach for Projects:
A. Deterministic Forecasting (Base Case):
● Uses finalized designs and confirmed schedule
● Typical forecast accuracy: 85-90%
● Applied to 60-70% of project materials
B. Range Forecasting (Scenarios):
● Creates upper and lower bounds based on likely scope variations
● Typical range: ±15% from base forecast
● Applied to discretionary or value-engineered items
C. Sensitivity Analysis:
● Identifies materials most sensitive to scope or schedule changes
● Prioritizes flexibility in procurement for high-sensitivity items
Practical Example: Commercial Office Tower
Base Forecast: 45,000 interior wall panels
Scenario Planning:
- Conservative (Lower Bound): 38,000 panels (scope reduction, value engineering)
- Base Case: 45,000 panels (current design)
- Aggressive (Upper Bound): 52,000 panels (scope expansion, premium finishes)
Procurement Strategy:
- Firm order: 38,000 panels (firm commitment)
- Optional commitment: 7,000 panels (supplier reserves capacity; project exercises with 4-week notice)
- Optional commitment: 7,000 panels (different supplier; longer lead time but lower cost)
Outcome: Project maintains flexibility without carrying excess inventory or risking shortages.
7. Establish Inventory Performance Metrics and Continuous Improvement
Effective inventory management requires disciplined measurement and feedback loops.
Critical Inventory KPIs for Project Industries:
KPI | Formula | Target | Insight |
Inventory Accuracy | (Actual stock / System records) × 100 | >98% | Identifies data quality and theft issues |
Days Inventory Outstanding (DIO) | (Avg. inventory value / Daily material consumption) | 15-30 days | Lower is better; high DIO = excess stock |
Stock-Out Rate | (Unplanned expedite events / Total deliveries) × 100 | <2% | Measures planning effectiveness |
Excess/Obsolete Inventory | (Unused materials at project close / Total inventory) × 100 | <5% | Identifies forecasting accuracy problems |
Carrying Cost Ratio | (Annual carrying cost / Avg. inventory value) × 100 | 20-35% | Justifies VMI and JIT strategies |
Procurement Lead Time Compliance | (Supplier orders received by need date / Total orders) × 100 | >98% | Measures supplier reliability |
Material Cost Variance | (Actual cost – Planned cost) / Planned cost × 100 | ±5% | Identifies pricing and specification issues |
Continuous Improvement Process:
- Monthly Inventory Reviews: Analyze KPIs by project phase and material category
- Variance Analysis: Investigate significant deviations from plan
- Supplier Performance Reviews: Quarterly assessments of on-time, quality, and responsiveness
- Lessons Learned Capture: Document what worked and what didn’t by project type
- Best Practice Standardization: Embed proven techniques into project templates and procedures
Common Pitfalls to Avoid in Inventory Management for Project Industries
1. Over-Procurement to “Hedge” Risk
● Problem: Planners buy excess material to avoid potential shortages, creating waste
● Solution: Use range forecasting and option contracts instead of carrying excess stock
2. Siloed Planning Between Projects
● Problem: Individual project managers procure independently, missing opportunities for consolidation
● Problem: No mechanism to reallocate excess from one project to another
● Solution: Centralized procurement governance and inventory sharing protocols
3. Ignoring Supplier Lead Times
● Problem: Materials ordered too late; expedite fees and rushed shipments inflate costs
● Solution: Implement lead-time analysis as part of schedule development; set procurement triggers 12-16 weeks in advance
4. Poor Inventory Data Quality
● Problem: System records don’t match physical inventory; planners lose trust in data
● Solution: Implement cycle counting, RFID tracking, and regular physical audits
5. Inadequate Storage and Site Conditions
● Problem: Materials deteriorate due to weather exposure, poor handling, or theft
● Solution: Invest in proper storage infrastructure; implement inventory security protocols
Key Takeaway
Project inventory management success depends on three pillars: precise demand forecasting tied to project schedules, flexible procurement strategies that accommodate scope change, and real-time visibility across the supply chain.
Organizations that master these techniques reduce carrying costs by 25-40%, improve project margins by 3-5%, and dramatically improve schedule reliability. The investment in planning discipline and technology pays dividends across the entire project portfolio.
